How to cost load and resource load a schedule in Primavera P6

Resource Loading in Primavera P6

Understanding Cost Loading

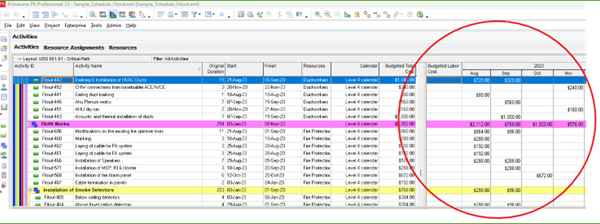

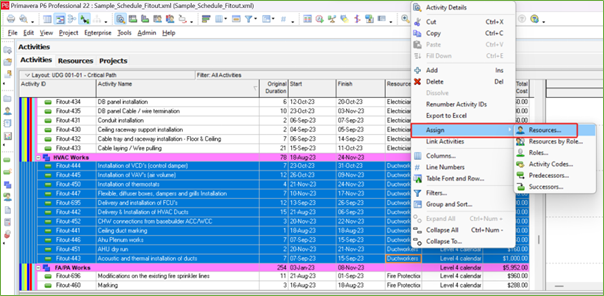

3. Review and Validate:

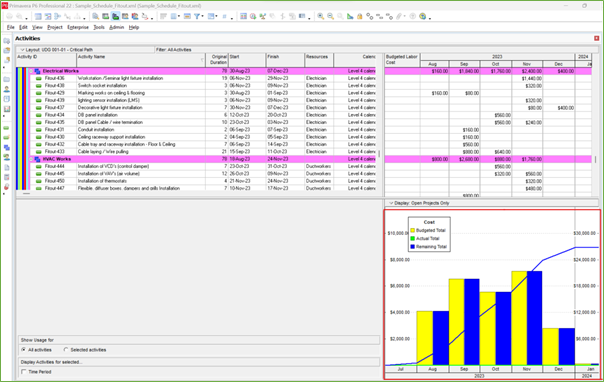

Validate the cost data and ensure that it accurately reflects the financial scope of the project. Make any necessary adjustments based on project requirements. Follow the same for the rest of the activities. Once the entire schedule is updated with the cost for all the set of activities, we can now track the schedule.

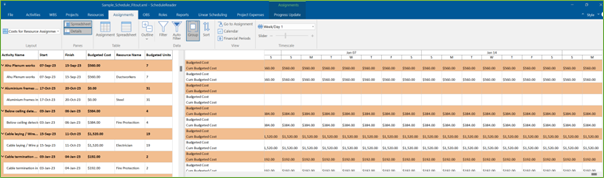

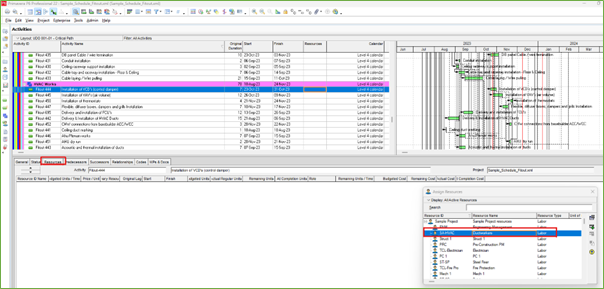

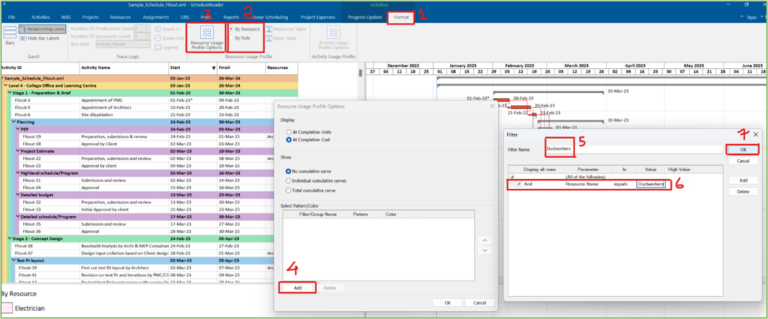

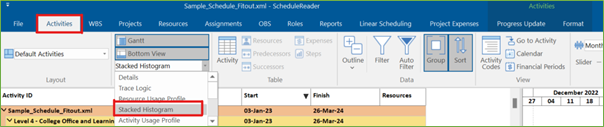

Activity usage spreadsheet

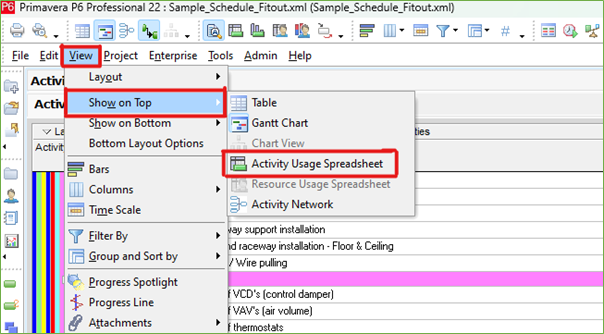

Go to view – show on top – activity usage spreadsheet.
