Reviewing Schedule Baselines with ScheduleReader

Baseline schedules are the cornerstone of every construction and engineering project. If you talk to any seasoned scheduler, they’ll emphasize how crucial the baseline schedule is for measuring performance, spotting…

Project Scheduling6 min read

Reviewing Schedule Baselines with ScheduleReader

Baseline schedules are the cornerstone of every construction and engineering project.

If you talk to any seasoned scheduler, they’ll emphasize how crucial the baseline schedule is for measuring performance, spotting deviations, and maintaining accountability.

Without a dependable baseline to compare against, planners can end up working without a reference point. They may understand where the project stands today, but they lose the context that shows how it got there or when it began drifting away from the original plan.

Understanding Baseline Schedules

What is a baselines schedule?

A baseline schedule is the initial, and “approved plan” that owners, general contractors, and project teams and relevant stakeholder all commit to when a project begins.

Schedulers freeze this “first approved” version of the schedule so that, as the project moves forward, they can measure performance and identify how much the actual work has deviated from the original plan. In context of construction and engineering schedules created by the Primavera P6 software, a schedule baseline is essentially a snapshot of the project plan at a defined moment in time.

In day-to-day schedule management, baselines are indispensable for a number of workflows and through baseline review we can:

  • Measure progress
  • Identify early or late activities
  • Track variances that impact milestones and critical paths
  • Monitor contractor performance and compliance
  • Understand the causes of project delays

The Challenges with Traditional Baseline Review Methods

Despite how essential schedule baseline analysis is, reviewing baseline data inside project plans often turns into a slow, complicated, or overly technical task.

The traditional methods, particularly when relying only on Primavera P6 or PDF exports, often make it harder than it should be. Schedulers end up spending time waiting for large project files to open, clicking through multiple menus, or even worrying about accidentally modifying the data in their system.

And that’s before the actual analysis even begins.

For many teams, reviewing baselines means opening Primavera P6, loading a large XER file, arranging columns, and then trying to navigate a heavy interface that is not always optimized for quick comparisons. Some of the challenges include

  • Large XER files loading slowly.
  • Accidentally modifying the schedule while trying to analyze it.

In addition, if only a handful of people in your organization can reliably review baselines, the process becomes unnecessarily slow and depends heavily on the scheduler’s availability.

Some teams rely on exported PDFs, particularly when communicating schedule details with field teams or subcontractors. Unfortunately, PDF exports strip away much of the dynamic functionality:

  • Lack of interactive views
  • Inability to filter, sort, or analyze variance data
  • Loss of context around activity relationships
  • Difficulty understanding the full picture when comparing multiple baselines

Given the complexity of modern construction schedules, these limitations make baseline review more time-consuming than it should be.

ScheduleReader for Baseline Reviews

ScheduleReader allows schedulers to review project baselines without the risk of overwriting any data. It provides a read-only view into schedules, so there is no danger of accidental changes.

That alone is a major advantage for many organizations.

The application provides full visibility into the project schedule, through its many dynamic views, and allows users to interact with the project data in different ways. It has a special built in baseline comparison feature that includes:

Baseline Support for XER and XML Files

Schedulers can import up to 4 project baselines in the .XER file format.

ScheduleReader can also visualize the project data using .xml files. If the XML schedule contains Baselines within the project file, they can add/import these as well.

In this way, users can view the project, primary, secondary, and tertiary baseline. This makes comparisons clearer and helps schedulers evaluate multiple performance perspectives.

These baselines may serve different purposes depending on the organization. For example, the primary baseline is usually the contractual one. A secondary baseline might be used to track internal goals. Tertiary baselines can be used for additional benchmarking and more.

Visual Baselines Analysis

In the ScheduleReader Gantt chart, you can see the graphical presentation of the Baselines bars given right below the original activity bar.

This visual comparison makes slippage and delays easy to spot at a glance.

Many schedulers find that visual comparisons reveal issues faster than variance columns alone. It is also the starting point for Project Risk Analysis with ScheduleReader, since a slipped baseline is the first sign of trouble.

Baselines

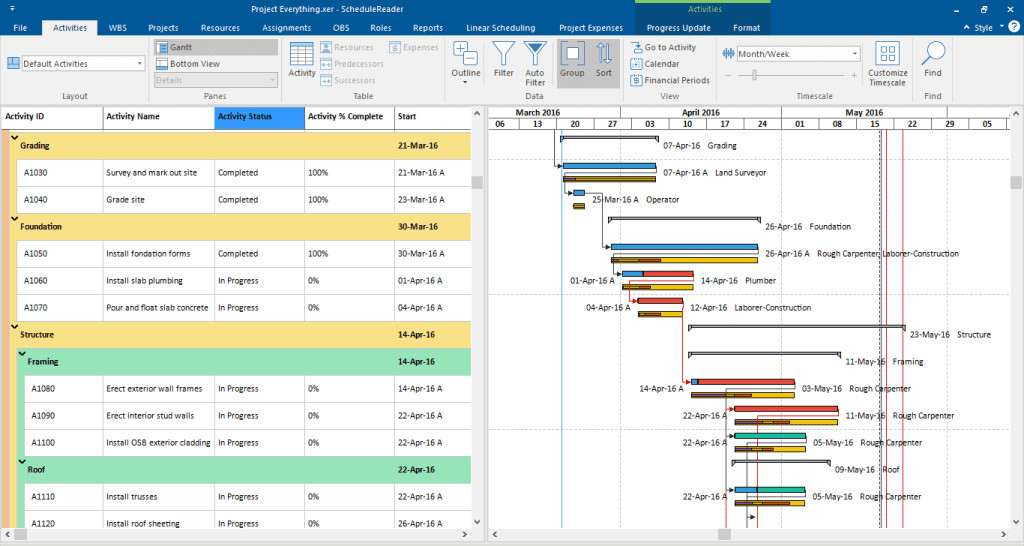

In our example we can see the color-coded Baselines on the Gant Chart:

  • Light yellow bar shows the Project baseline
  • Orange bar shows the Primary baseline
  • Dark yellow bar shows the Secondary baseline
  • Purple bar shows the Tertiary baseline

Providing different customization options to the view data, ScheduleReader makes it easy for users to modify the colors, remove labels, and even hide bars from the Gantt chart.

The following video illustrates the process:

Using the Activity Table Columns for Baseline Analysis

ScheduleReader can display baseline fields such as Baseline Start, Baseline Finish, Start Variance, Finish Variance, and Total Float Variance and more in the column view as well.

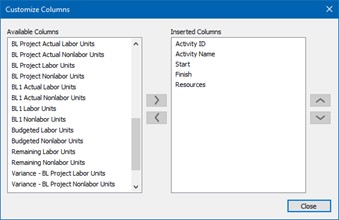

Baseline fields

Schedulers can sort and filter these fields, which helps highlight the most critical deviations.

Graphical Reports

In the PRO version, ScheduleReader features special reporting functionality, allowing you to visually compare baseline and actual data.

Through the Activity metrics report you can quickly create a report type summary that includes a detailed comparison between the current version of the project plan and the active baselines.

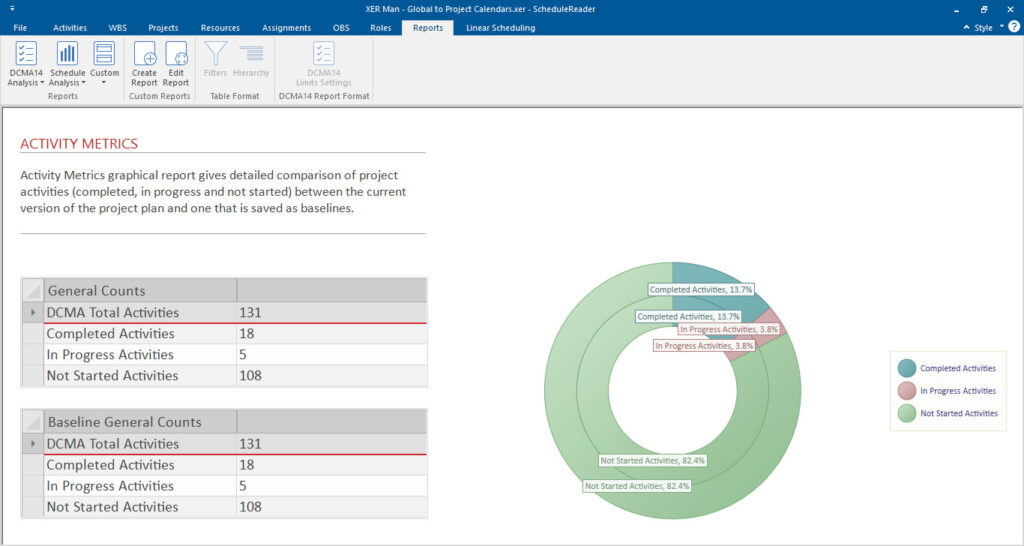

Activity metrics report

Activity Metrics Report

Similarly, the Project and WBS report types related to duration, units, costs can be used with Baseline data parameters for further analysis.

Beyond Baseline Reviews – Compare Projects Feature

ScheduleReader also provides the Compare Projects feature that allows you to quickly compare the current project state against a different version of the project schedule with the same project ID and identify any changes between the two schedules side-by-side.

This feature will help you to get clear insights into what has changed between the two projects.

The Gantt chart will display the schedule modifications, task shifts, and dependency changes, while through the columns in the Activity Table view will provide you with a detailed, line-by-line breakdown of specific changes to tasks, durations and other project parameters.

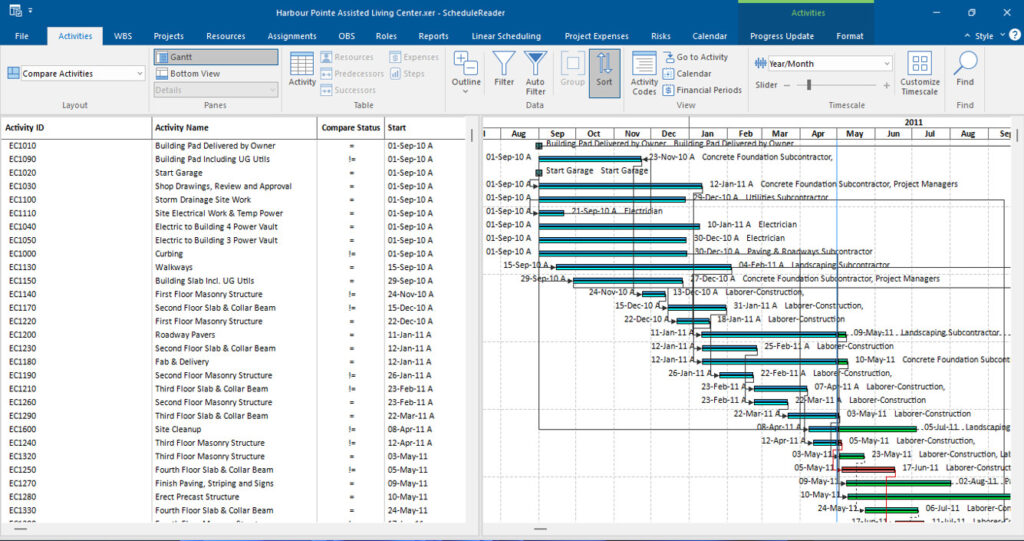

Compare projects

How ScheduleReader Saves Time for Project Teams

Across the industry, one of the most common pieces of feedback from schedulers is that ScheduleReader simply saves time. When schedules grow large and teams grow busy, every minute counts.

ScheduleReader speeds things up in several ways:

  • Large XER files open quickly. The lightweight design makes it easy to view, filter, and analyze without performance slowdown.
  • It improves cross-team communication because subcontractors and engineers can review the schedule with only one tool, ScheduleReader.
  • It gives project stakeholders a more transparent view of schedule performance.

And most importantly, it provides a fast and simple way to perform baseline analysis of the project schedule or compare two versions of a project side-by-side.

Conclusion

Baseline reviews are a cornerstone of effective construction schedule management. Without them, it’s nearly impossible to understand project performance and identify deviations.

Tools such as ScheduleReader provide a reliable, intuitive, and fast alternative for viewing project schedules and analyzing schedule baselines. ScheduleReader quickly loads schedules and provides read-only access to project data, which is a relief for anyone who has ever mistakenly edited a schedule they only meant to inspect.

Over the past several years, it has become one of the go-to tools for project teams that want a more efficient way to review construction schedule baselines and view schedule data using the .xer and .xml file formats instead of static PDF files.

If your organization is looking to streamline baseline reviews and improve collaboration around schedule data, ScheduleReader is well worth considering.

Try ScheduleReader today and download the 15-day free trial:

ScheduleReader
